Carbon capture and storage (CCS)
KiNESYS represents CO2 transport and storage (T&S) with country-level supply curves built from plant-level emitter locations and site-level storage geometries, and constrains CO2 injection with pressure-limited physics — replacing the legacy treatment (global potentials from Hendriks 2004 / Dooley 2005 downscaled by weight attributes, flat cost steps, no injection-rate constraint).
Four features distinguish this treatment from standard global ESOM practice:
Spatially grounded T&S costs. Every GEM-tracked steel, cement, and power plant is matched to its cheapest viable storage option (onshore pipeline, offshore pipeline, or ship); costs come from engineering-economic pipeline functions with direction-aware trunk-sharing, not from a flat $/t adder.
Injection rates as physics, not stock fractions. Per-region injection-rate ceilings derive from basin-scale pressure-buildup modeling (CO2BLOCK class), so under-assessed regions (India, Brazil) are not starved by assessment-coverage bias.
Co-varying supply-curve steps. Each step carries capacity, injection-rate share, T&S cost, and a quality/provenance tier jointly — the model sees that a cheap tranche may also be the rate-limited or speculative one.
Deployment realism as scenario-bounded ceilings. Per-country deployment ceilings anchored on each country’s actual project pipeline, historical technology-analog growth rates, and projected capturable emissions — a pessimistic/optimistic pair that prevents the optimizer from deploying CCS anywhere faster than institutions plausibly allow, while leaving the cost-driven allocation within those bounds to the model.
The source-sink geography behind the supply curves: global sedimentary basin footprints (Gidden et al. 2025 screening classes, darker = assessed) and the ~7,500 GEM-tracked capturable point emitters (coal and gas power, steel, cement; marker size ∝ emissions). Distances from each plant to its viable sinks drive the transport-cost differentiation.
Storage supply
Each country’s storage is broken into steps of
category x distance-band x quality-tier x sink-mode:
Dimension |
Values |
|---|---|
Category |
Saline aquifer; Petroleum (depleted fields; undiscovered-petroleum excluded) |
Distance band |
0–50 / 50–200 / 200–500 / 500–1500 / >1500 km (emitter-to-sink, emissions-weighted) |
Quality tier |
Q1 directly assessed sites (OGCI); Q2 assessed basins / prudent tranche; Q3 unassessed or proxy |
Sink mode |
Onshore pipeline; offshore pipeline; offshore ship |
Capacity is anchored on the OGCI CO2 Storage Resource Catalogue (Cycle 5, site-level P10/P50/P90), with CO2StoP (EU), the Fan et al. (2025) fine-grid dataset (China), and oil & gas field proxies (OGIM) — tier discounts and thin-catalogue gap-fill are quantified on the Gidden et al. (2025) nesting of technical potential, prudent (suitability-screened) limit, and O&G-infrastructure overlap. NatCarb (US) serves as an informational cross-check only.
Injection-rate and deployment constraints — three layers
Layer 1 — regional physical ceiling. Pressure-limited injection rates per basin from an open-parameter CO2BLOCK re-run over the 765-basin skeleton of Smith et al. (2024), calibrated to their published global physical maxima, apportioned to supply-curve steps by capacity, and emitted as ACT_BND per region and process at every milestone year (declining from the 30-year to the end-of-century rate, reflecting basin pressurization; interpolation is precomputed — no TIMES-side interpolation is relied on). China uses explicit fine-grid rates; petroleum uses voidage replacement. The ceiling is deliberately loose (global saline sum an order of magnitude above deployment scenarios): it binds only where basins are genuinely small.
Layer 2 — global deployment build-rate. A single global user constraint
(GLB_CO2Sto_BuildRate) caps total storage activity along a logistic ramp calibrated on
the Zhang, Jackson & Krevor (2024) Monte Carlo growth model (Low / Central / High; Central
D(2050) ≈ 5.6 Gt/yr). Because the budget is global, the model allocates scarce deployment
capability across regions economically — no per-region rescaling, no starvation of
under-assessed emitters.
Layer 3 — per-country deployment ceilings (pess/opt scenario pair). Geology bounds what a
basin can take (Layer 1) and global industry dynamics bound how fast the world can build
(Layer 2), but neither stops the optimizer from concentrating the entire global budget in one
cheap region — unconstrained runs deploy China at 2.3 Gt/yr by 2030, a rate no jurisdiction
has approached. Hard per-country Mtpa ceilings (2030–2070) close this gap, literature-anchored
at every parameter and emitted as two scenario blocks (DeployPess / DeployOpt) that
run alongside — not instead of — the global build rate:
2030 anchor: the country’s actual project pipeline from the IEA CCUS Projects Database (2026 edition) — operational and under-construction storage capacity plus attrition-weighted planned capacity (optimistic keeps 60% of plans, pessimistic 10%; attrition rates citable to Kazlou et al. 2024, Abdulla et al. 2020, Wang et al. 2021).
Growth phase: the Kazlou et al. (2024) technology-analog ladder — optimistic follows wind’s 2000s growth (26%/yr) then nuclear’s 1970s (16%/yr), decaying to mature-industry rates; pessimistic holds CCS’s own historical 8%/yr throughout. Where Zhang et al. provide fitted national growth distributions, the ladder is cross-checked and capped at the fitted 90th percentile (this binds for Indonesia).
Asymptote: capturable emissions — 85% of the country’s capturable base (optimistic), or cement + steel + a quarter of power (pessimistic) — projected along country-resolved SSP2 baseline pathways (Gütschow et al. 2021), so late-century headroom grows where emissions grow (India, SE Asia).
The most instructive output is China: its optimistic 2050 ceiling is ~0.7 Gt/yr despite world-class geology, because its project pipeline is thin — the ceilings encode institutional readiness, which neither geology nor global growth dynamics capture. Countries without characterized storage receive no ceiling (absent capacity bounds them at zero); countries with storage but no projects are seeded with a small takeoff (1.0 Mt from 2035 optimistic / 0.3 Mt from 2040 pessimistic). Global brackets validate against independent markers: 2030 pess/opt of 0.16/0.42 Gt/yr contains the Kazlou-feasible 0.37; 2050 of 0.78/6.44 Gt/yr contains both the current-trajectory extrapolation (~0.7) and the Zhang Central 5.59; the USA optimistic 2050 ceiling (1.72 Gt/yr) sits at the Princeton NZA high case (1.7).
Transport and storage costs
Emitters (GEM steel and cement trackers with route-resolved emission factors; the GEM power fleet) are assigned to sinks by geodesic distance per country. Pipeline costs follow McCoy & Rubin engineering economics with diameter economies of scale and regional construction factors; corridor flows are shared among co-assigned plants (direction-aware trunk-sharing). Ship transport (liquefaction + port + vessel) engages beyond the pipeline/ship crossover and is decisive for coastal emitters far from onshore basins (Japan, Korea). Countries with major CCS policy restrictions (per Gidden et al. S4) have onshore storage demoted. Storage unit costs use ZEP/NETL anchors by category and tier.
Resulting country averages (emissions-weighted) span roughly $7/t (USA) to $28/t (Japan) with ship-dominated Korea higher — consistent with the Smith & Herzog (2021) $4–45/t envelope, and with the finding that whether transport matters is strongly geography-dependent.
Pessimistic cost scenario (PessCost). Alongside the central curves, a deliberate cost bound stacks five individually citable pessimisms multiplicatively: regional-high transport (×1.4, Baek et al.), no hub coordination (every plant pays plant-scale pipeline costs — the trunk-sharing adjustment disabled), ZEP high-case storage anchors, a brine-handling (pressure-management) adder on unappraised saline tranches (Anderson 2019/2020), and a first-of-a-kind premium of +50% fading to zero by 2045 (Rubin’s FOAK/NOAK convention; overrun evidence per Rasool 2025). Because the pessimisms stack, PessCost sits outside any single literature anchor by construction: Japan/Korea-type curves reach $54–87/t, intentionally breaching the Smith & Herzog envelope. It brackets T&S cost risk and must not be read as a central estimate.

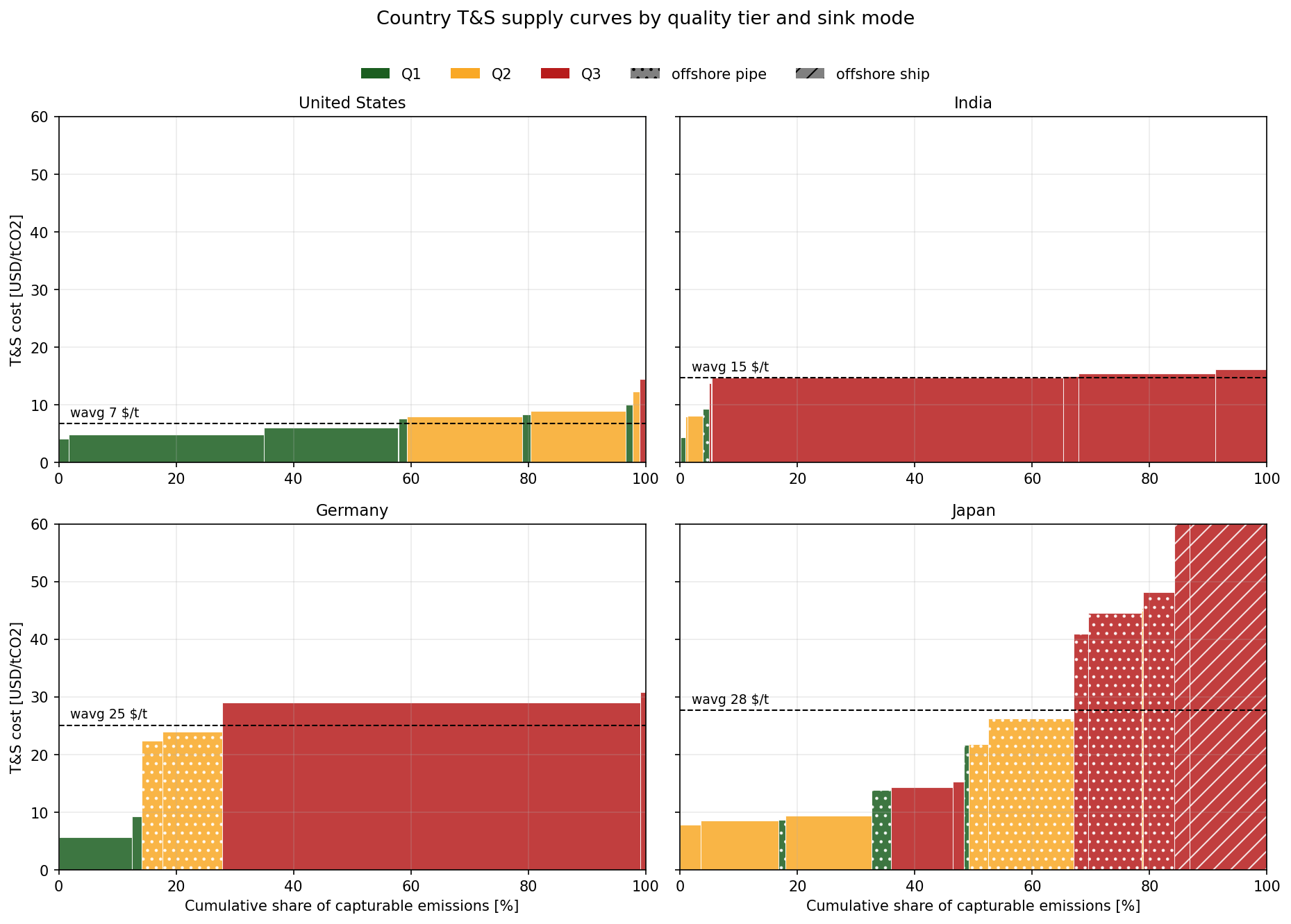

Country T&S supply curves (steps colored by quality tier, hatched by offshore mode). Four archetypes: the US is cheap and assessed (Q1/Q2); India is cheap on distance but unassessed (Q3 dominates — screening, not resource, binds); Germany is policy-restricted onshore with a North Sea offshore option; Japan puts 40% of its capturable emissions on offshore pipelines and moves onto ship for the ~16% beyond the ship crossover (~80% of the curve).

Emissions-weighted average T&S cost for the 25 largest emitter countries. The spread — $7/t (USA) to >$50/t (Korea, Taiwan) — is the regional differentiation that a flat global $10/t assumption erases.
Validation
The dataset is validated against seven benchmarks: the NZA US deployment rate and well arithmetic, Lin et al. (2024) China steel T&S component, the Smith & Herzog cost envelope, announced-hub locations falling in the cheapest steps, ceiling-ordering checks, and the Smith et al. (2024) cross-country distribution of pressure-limited resources. The deployment ceilings carry their own bracket checks (Kazlou-feasible 2030 capacity, Zhang Central 2050, NZA USA high case) plus a per-country cross-check against the Zhang fitted national distributions, and a structural guarantee that the pessimistic trajectory never exceeds the optimistic one.
Known limitations
Emitter locations are today’s plant stock; transport is distance-band-averaged (no routing or endogenous network investment); cross-border sink-sharing (e.g. Northern Lights) is a model representation question, not a dataset property; offshore permeability priors are weak for the North Sea, Red Sea, and NW Shelf, making UK/Norway/Yemen/Australia physical ceilings conservative.
For the deployment ceilings specifically: values beyond 2070 are held flat; ceilings exist only for countries with characterized storage (a deliberate scope decision — countries without it are bounded at zero by absent capacity anyway); import-driven storage growth (Iceland-type mineralization hubs serving foreign CO2) is out of scope, so such countries hold at their project-pipeline anchor. And because ceilings sum linearly within a model region, they lose bite where a large emitter shares a region with storage-rich neighbours — the build reports every region that merges a top-20 emitter with other countries (e.g. Germany inside a single EU region, or Southeast Asian emitters pooled in an Asia-other region), so the regionalization choice is made consciously per model instance.
Data sources
Key sources: OGCI CO2 Storage Resource Catalogue Cycle 5; Smith, Hampson & Krevor (2024, IJGGC); De Simone & Krevor (2021, IJGGC — CO2BLOCK); Gidden et al. (2025, Nature); Zhang, Jackson & Krevor (2024, Nature Communications); Fan et al. (2025, Scientific Data); CO2StoP (EU JRC); NETL NatCarb; OGIM v2.7; Global Energy Monitor steel/cement trackers; McCoy & Rubin (2008); Kim et al. (2024); Baek et al. (2026); ZEP (2011); Smith, Morris & Herzog (2021); Larson et al. (2021, Princeton Net-Zero America); Lin et al. (2024).
For the deployment ceilings and PessCost: IEA CCUS Projects Database (2026 edition); Kazlou, Cherp & Jewell (2024, Nature Climate Change); Abdulla et al. (2020, Environmental Research Letters); Wang et al. (2021); Gütschow et al. (2021, Earth System Science Data — country-resolved SSP pathways); Anderson (2019/2020, IJGGC — active pressure management); Rubin et al. (FOAK/NOAK convention); Rasool et al. (2025).
